Even as construction finally begins on Sacramento Republic FC’s long-awaited Railyards stadium, the club is already looking beyond its 12,000-seat opening capacity. A new application filed with the City of Sacramento outlines plans for a Phase 2 expansion to as many as 20,000 seats by 2028, hinting at a scale of ambition that goes well beyond simply opening the doors in 2027.

It’s an early signal that the club is building with long-term growth in mind—and possibly preparing for something bigger.

A Forward-Thinking Phase 2, Already in Motion

According to the filing, the project team has already begun the procedural steps necessary to make a rapid expansion possible. The application notes that these moves ensure “an optional Phase 2 expansion can be completed in an expedited and cost-effective manner.”

The proposed timeline is aggressive:

  • May 2026: Begin foundations and footing work for the expansion

  • Early 2027: Main stadium opens

  • November 2027: Begin vertical construction for Phase 2 after the club’s first Railyards season

  • January 2028: Complete structural work, landscaping, paving, and site improvements

This is not a typical wait-and-see model. Instead, it’s proactive infrastructure planning that allows Sacramento to scale up quickly if demand—and opportunity—continue to grow.

What Phase 2 Includes

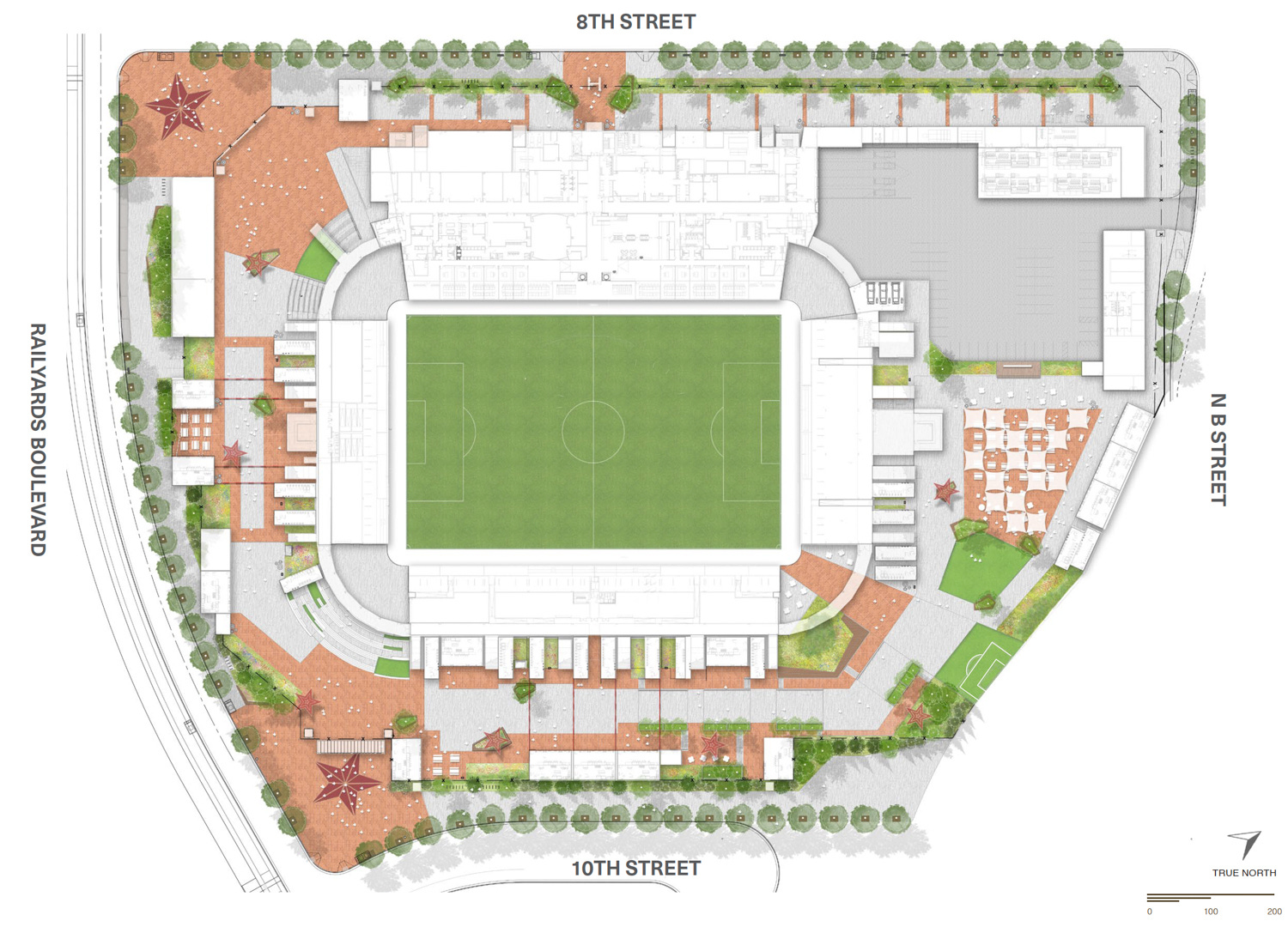

The expansion would significantly reshape the stadium’s profile:

  • Increase capacity from 12,000 up to 20,000

  • Add 18 new suites, bringing the total to 27

  • Construct a new metal deck and extended roof membrane to complete the upper tier

The design follows what was previously reviewed during the club’s earlier design submissions, but the timeline is the most eye-catching part. If executed as outlined, Sacramento could play its second season in the Railyards with a nearly doubled capacity months later.

A Return to Big Ambition

This isn’t the first time Republic FC has imagined a larger stadium. In 2017, the club secured preliminary approvals for a venue that could eventually reach 25,000 seats—a number tied to its then-forthcoming entry into MLS. That bid ultimately fell apart when Ron Burkle withdrew from ownership in 2021.

But the new filing raises an obvious question, Is Sacramento quietly positioning itself for another MLS push?

Earlier this year at the stadium groundbreaking, Wilton Rancheria leadership publicly stated they were in active conversations with other Native American tribes across California about investing in the club—specifically if MLS became a real possibility again.

That comment didn’t make headlines at the time, but paired with a detailed expansion plan filed just months later, it resonates differently now.

Even if no MLS bid is currently underway, the club’s strategy appears clear:

They are building flexibility into the stadium’s long-term roadmap, ensuring that Sacramento never again misses out on an opportunity because the infrastructure wasn’t ready.

What This Means for Sacramento

If pursued, a 20,000-seat stadium would position Republic FC among the largest clubs in the USL ecosystem and strengthen Sacramento’s profile in the emerging USL Division One era. It could help bring larger events, increase matchday revenue, and reinforce the club’s role as an economic anchor in the Railyards.

And if MLS does circle back to Sacramento—whether through revived local investment, new ownership partners, or league expansion—Republic FC would already have a stadium blueprint capable of matching the moment.
